Six-cabin reroof · Sheet A1HAGAR TWP · MI · 2026-09

Steel
or
Shingle.

Two ways to reroof six A-frames without tearing off what’s there. Each row asks the same question of both options.

OptionA · Insulated steelB · Shingle overlay
Six cabins$46,253$27,969
Per cabin$7,709$4,661
Insulation2″ polyiso addedNone
Roof edge+3½″ plus steel profile; deeper trimThin overlay; slim flashing
Open itemsDelivered steel price · insulation suitabilityNail penetration · steep-slope sealing

Shingle overlay: $18,285 less across six cabins.

01 · Existing cabin

Geometry fixed by the frame.

Six cabins in Hagar Township, Michigan. The existing structure sets the dimensions for both roof options. Deck: 148″ wide × 5′6″ deep. Footings: 148″ outside-to-outside.

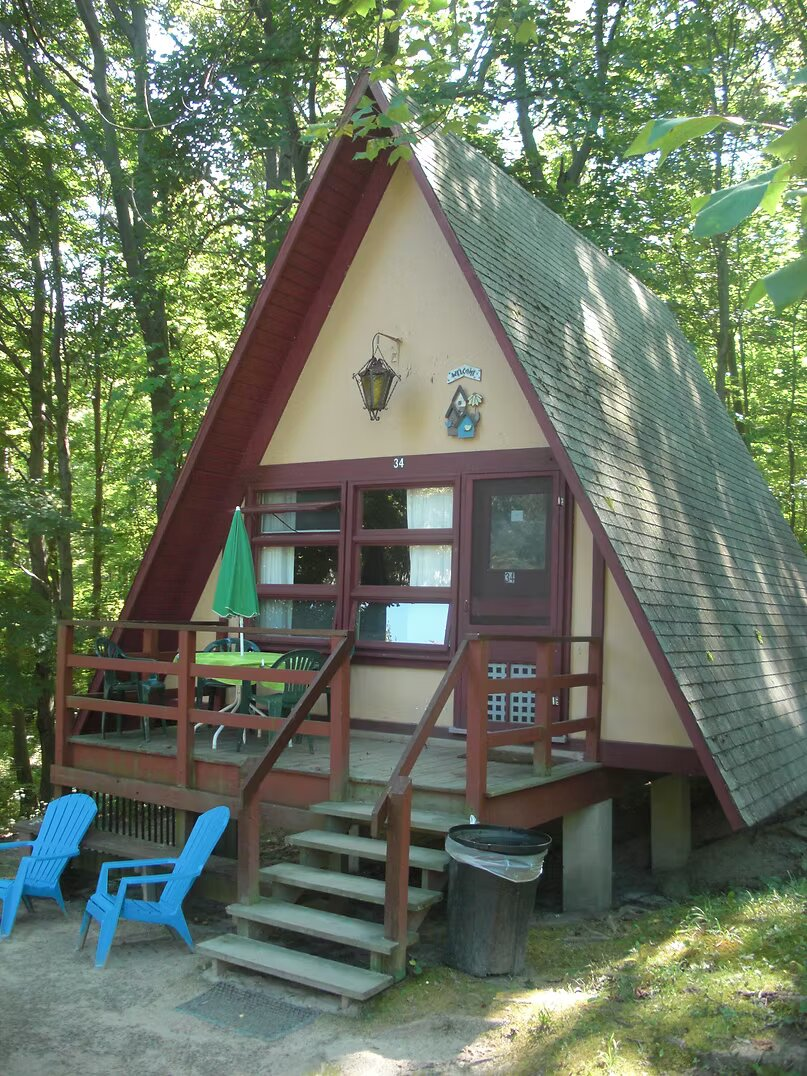

Existing A-frame cabin 34 with exposed wood overhang, front porch and asphalt roof

FIG 1 · OWNER PHOTO · CABIN 34

Roof dimensions20′ × 24′

Each sloped face. 20′ horizontally between the lower outside roof edges.

Four frames6′ 8″ bays

One beam pair at each end wall and two evenly spaced between.

Interior crossbeam underside8′ above floor

End crossbeams start at the door head. Matching bottom ties sit beneath the floor.

Front & back overhang24″ each

Exposed wood undersides remain visible.

Opening dimensions & scope notes

Confirmed deck depth: 5′6″ from the front wall outward.
Provisional opening sizes: 32″ × 80″ door leaf; front bank of two 30″ × 54″ window units; rear bank 50″ overall including trim. Window sills are 26″ above the floor. Door jamb and screen envelope: approximately 34″ × 82″. These are model assumptions to verify on site, not ordering or rough-opening dimensions.

Both options retain the existing roof. Steel adds insulation and flat purlins; the shingle overlay adds starter, architectural shingles, ridge caps and edge flashing. Existing shingles and underlayment remain. No added downslope battens. No new soffit cladding.

02 · Layers

Section through each roof.

Compare the build-up, finishes, construction and complete six-cabin budgets side by side.

A / STEEL

Insulated steel roof

2″ insulation · flat 2×4 purlins · steel panels

3½″ added depth, plus steel profile. Individual foam sheets, staggered purlins, panels and trim.

B / SHINGLES

Architectural-shingle overlay

Starter · architectural shingles · ridge caps

Thin overlay over existing shingles. No new insulation, purlins or steel panels.

Same cabin · 20′ × 24′ per roof face · 960 sq. ft. per cabin
Orbit starts or stops all models. Drag while enabled; Esc stops all.

03 · Finish

Palette applies to both.

One palette updates both options, all models and both renderings.

A / STEEL

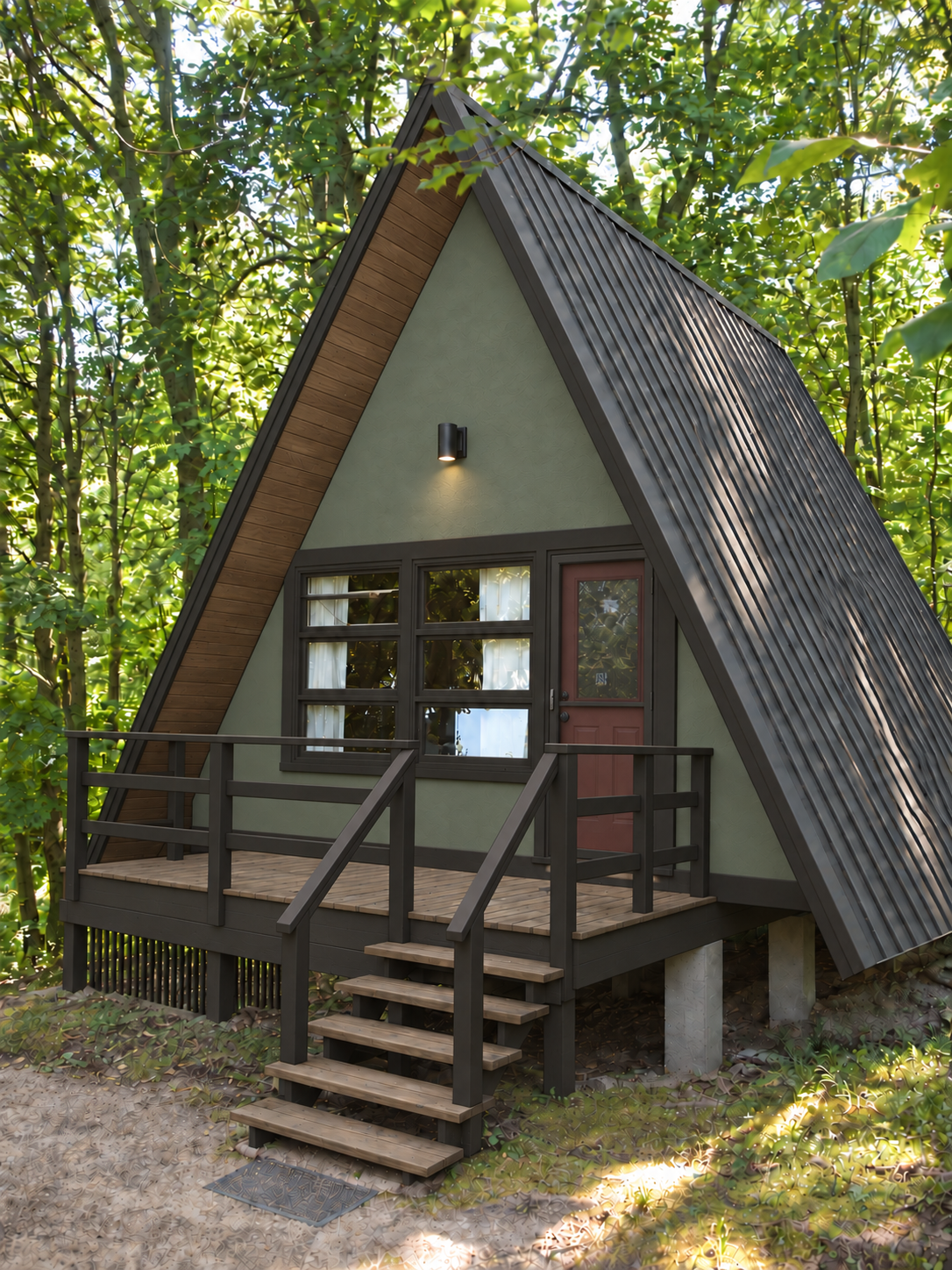

Insulated steel roof

Forest & oxblood · formed steel panels

Forest & oxblood cabin with steel roofing

Insulated roof build-up with deeper edge trim.

B / SHINGLES

Architectural-shingle overlay

Forest & oxblood · architectural asphalt shingles

Forest & oxblood cabin with architectural-shingle overlay

Low-profile overlay with slim edge flashing.

End walls
Rails, exposed beams & trim
Exposed T&G
Entry door

Renderings are color and material concepts. Use the dimensioned models for geometry; final product colors and details need confirmation.

04 · Sequence

Steps, in order.

Play both assemblies together, or scrub to a stage. Progress compares the sequences; it does not represent equal installation time.

A / STEEL

Insulated steel roof

Fasteners installed
Existing cabin
B / SHINGLES

Architectural-shingle overlay

Fasteners installed
Existing cabin
0%

Each material is fastened as it lands. Edge trim covers the deeper assembly.

Both roof faces install together. Nails follow each piece and are covered by the next course.

Construction notes & assumptions

Flights and fixings illustrate the assembly, not a work procedure or approved fastening schedule. For shingles, confirm overlay suitability, nail penetration through both layers and near-60° steep-slope fastening and hand-sealing requirements. Paint follows roofing on both options. Openings, fixtures and paint remain concepts pending field verification.

05 · Cost · Six cabins

Schedule of costs.

5,760 sq. ft. net roofing. Matching scope and allowances shown row by row. Owner labor is unpaid; tax and permit allowances are excluded.

Six-cabin roofing cost comparison in US dollars
Six-cabin estimateA / STEELInsulated steelB / SHINGLESShingle overlay
Field roofing$8,262$7,750
2″ insulation · 192 sheets$6,720
Insulation seam tape$600
Flat 2×4 purlins$2,298
Roofing & structural fasteners$3,480$600
Starter strips$440
Edge trim / flashing & ridge caps$5,100$2,161
Closures, sealants & hand-sealing$840$450
Edge backing / minor repairs$1,920$1,920
Materials subtotal$29,220$13,321
Paid helper · 40 days$8,000$8,000
Equipment / access$1,800$1,800
Delivery / handling$1,200$1,200
Contingency · 15%$6,033$3,648
Total project$46,253$27,969
Per cabin$7,709$4,661

Shingle overlay is $18,285 lower at the current steel price. It adds no insulation. A dash means the material is not part of that option.

Steel pricing basis

102 panels including six spares; 20′3″ pricing length and 2,065.5 LF total. The $4/LF target is not a quote. Insulation assumes 192 roofing-grade polyiso sheets at $35 each; facer and assembly suitability remain pending.

Shingle pricing basis

192 field bundles / 64 squares / approximately 6,400 sq. ft. purchased. Field-shingle allowance: $7,750; range $7,500–$8,000. Published bulk benchmark: 192 × $38.67 = $7,424.64, at 39+ bundles; not a confirmed local delivered quote.

Starter: 8 × 120 LF bundles, $439.76. Ridge caps: 7 × 25 LF bundles, $440.79. Edge flashing: 86 × 10′ pieces, $1,720 allowance. Nails: provisional 30,000, $600. Total range with only field-shingle pricing varied: $27,681$28,256.

Both options retain the existing roof and exposed wood. No new soffit cladding or downslope battens. Full repainting, doors, lights and deck improvements are excluded. Final attachments, roof condition, repairs and delivered quotes may change these allowances. Shingle overlay needs sound decking and confirmation of load suitability, nail penetration and near-60° steep-slope fastening and hand-sealing requirements.
